Site Progress Update: Exterior Works Completed, Podium and Terrace Advancements
Habitat 854
Kulambiro, Kampala
May 28, 2025
As we approach the final stages of construction, exciting progress continues across the site.
External plaster work is now 100% complete, giving the buildings their finished look and moving us closer to the final vision.

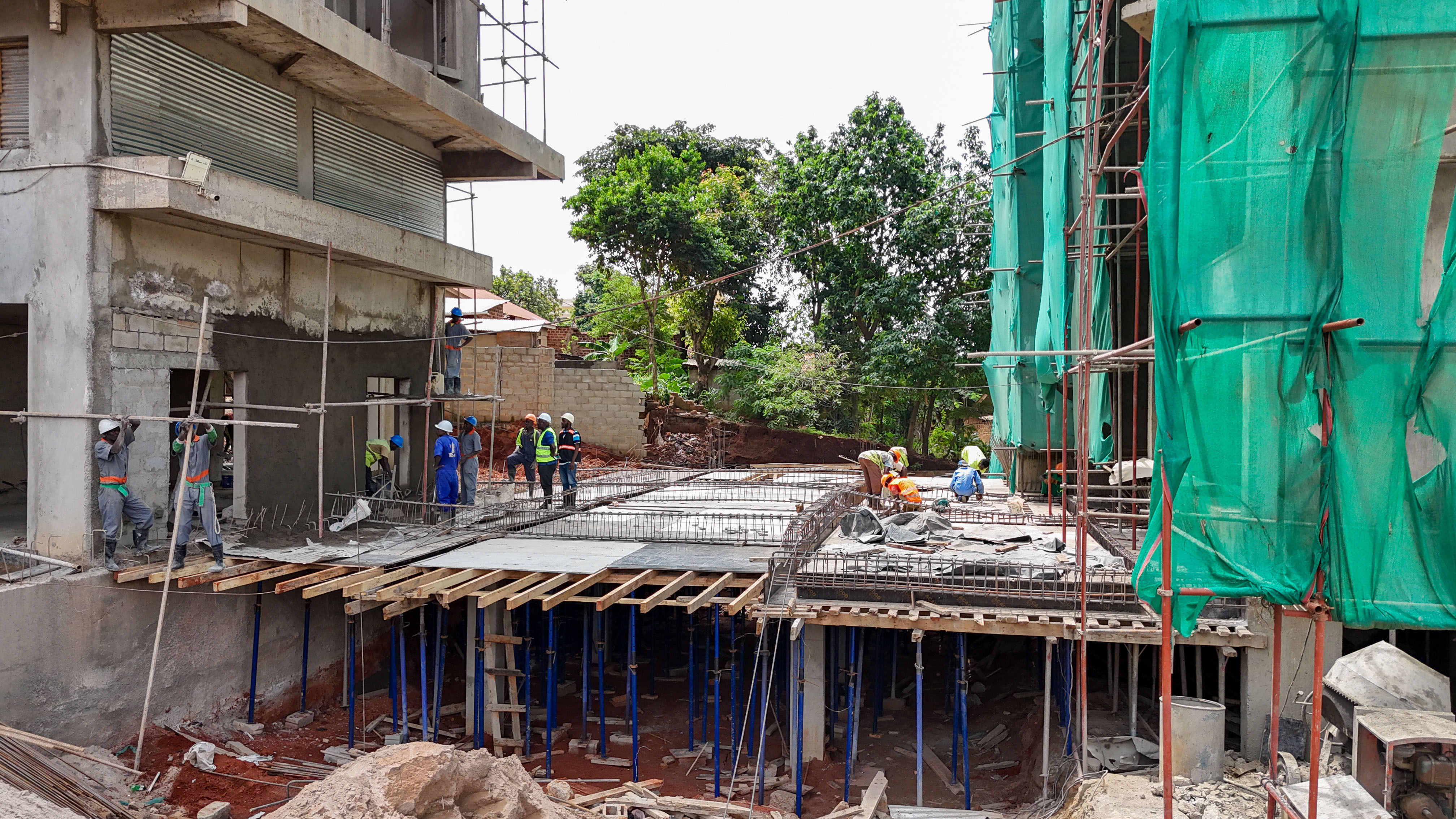

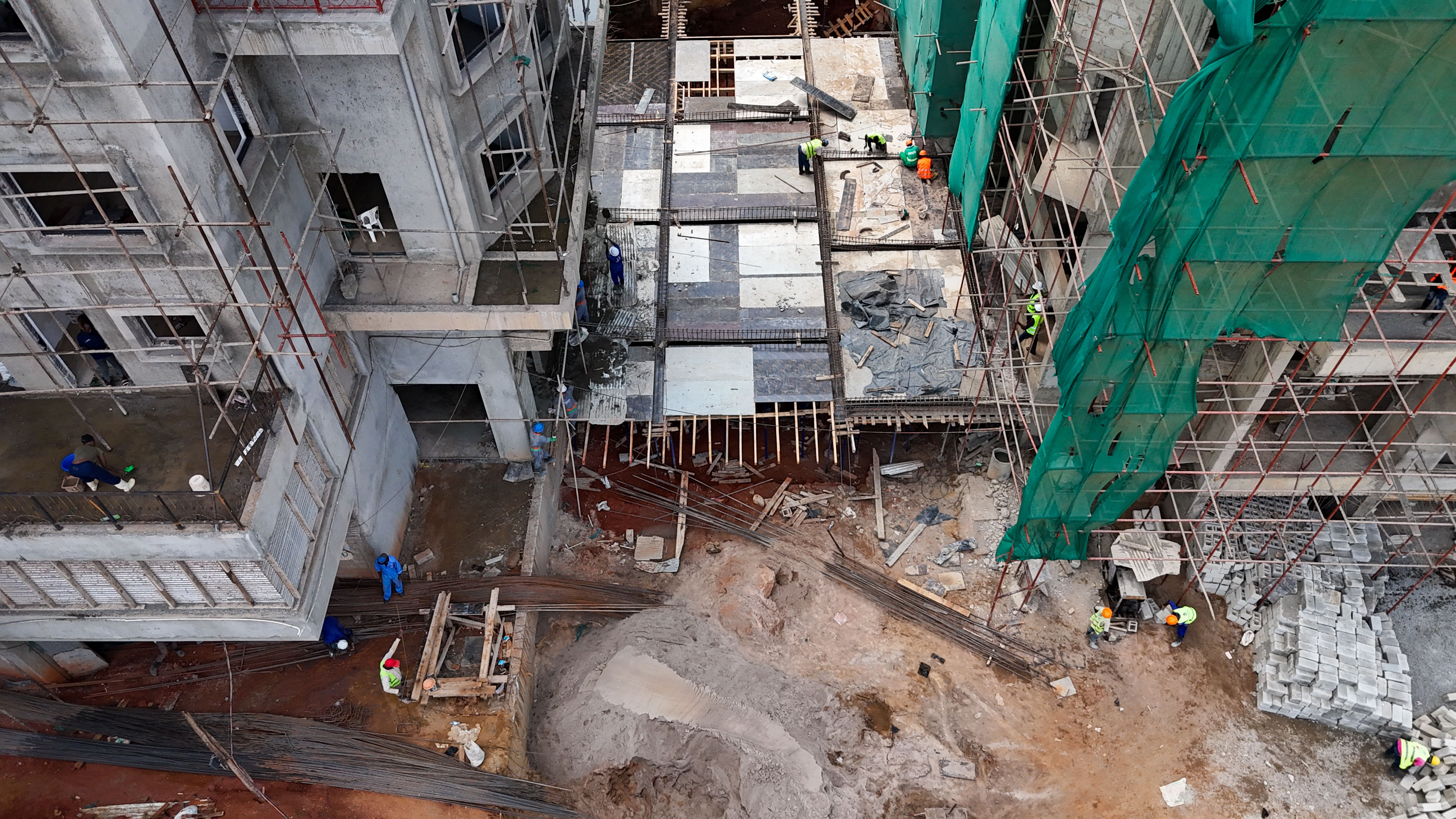

At the podium level, steel reinforcement and shuttering work is actively underway between Wings A and B, with a target to reach 50% completion soon.
On the lift and water tank slabs, teams in the red zone are carefully applying beautiful China mosaic, ensuring both durability and aesthetic appeal.
In the blue-marked areas, the final coat of waterproofing is being prepared, with tiling work starting to take shape.
In the yellow zone, the final paint for the skylight is done, and we’re now preparing to install sleek, reflective glass panels that will elevate the overall look.

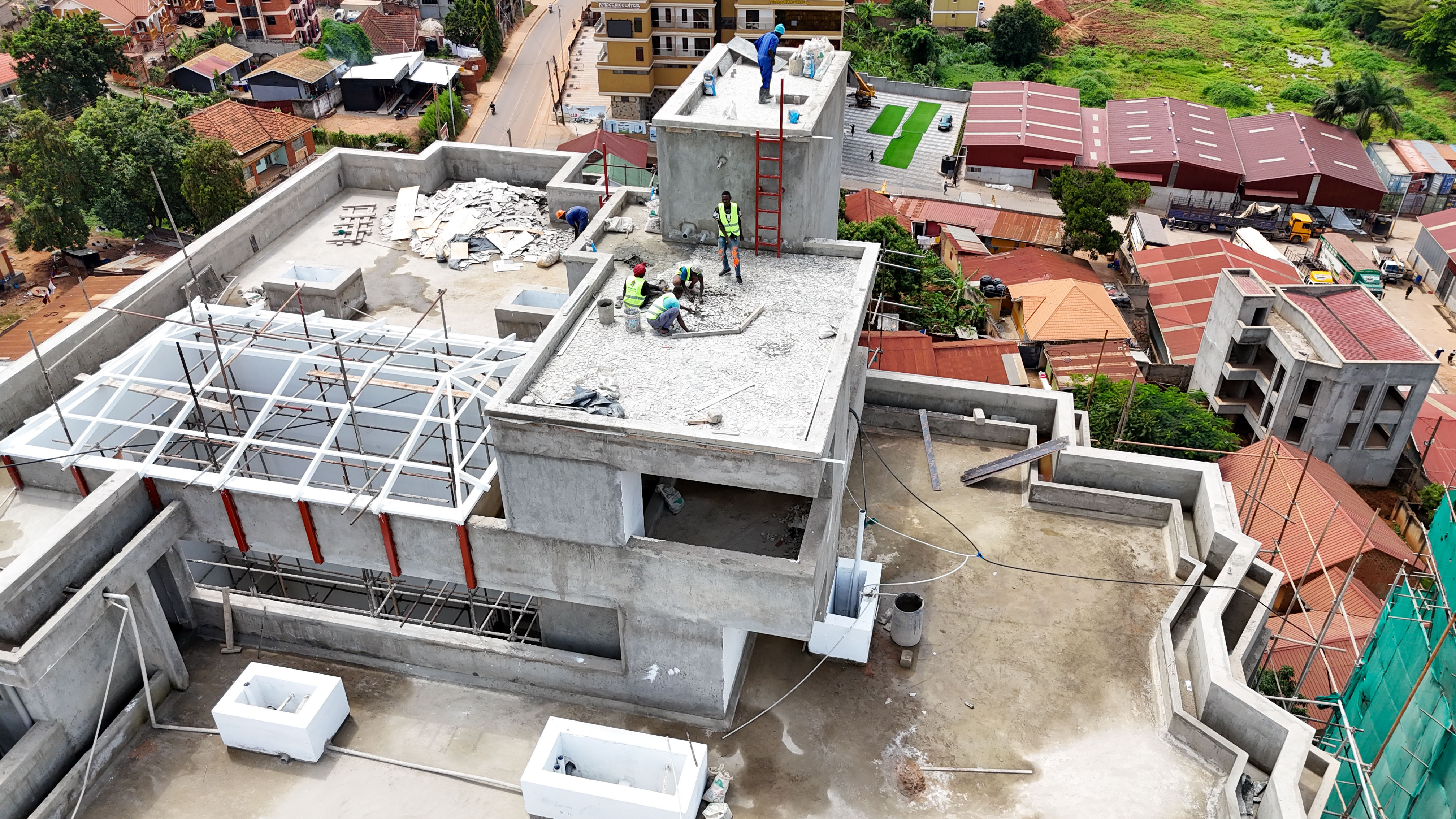

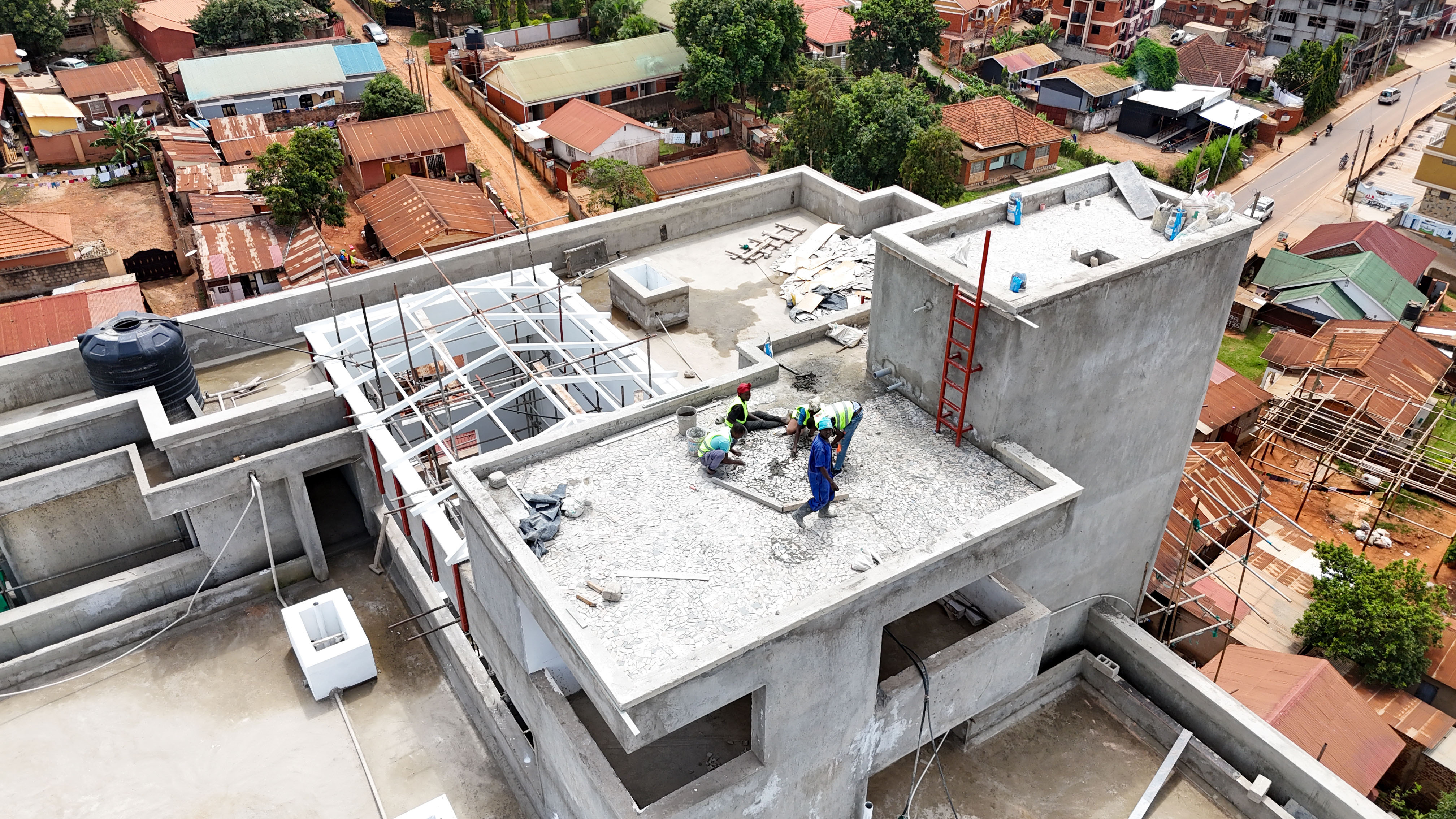

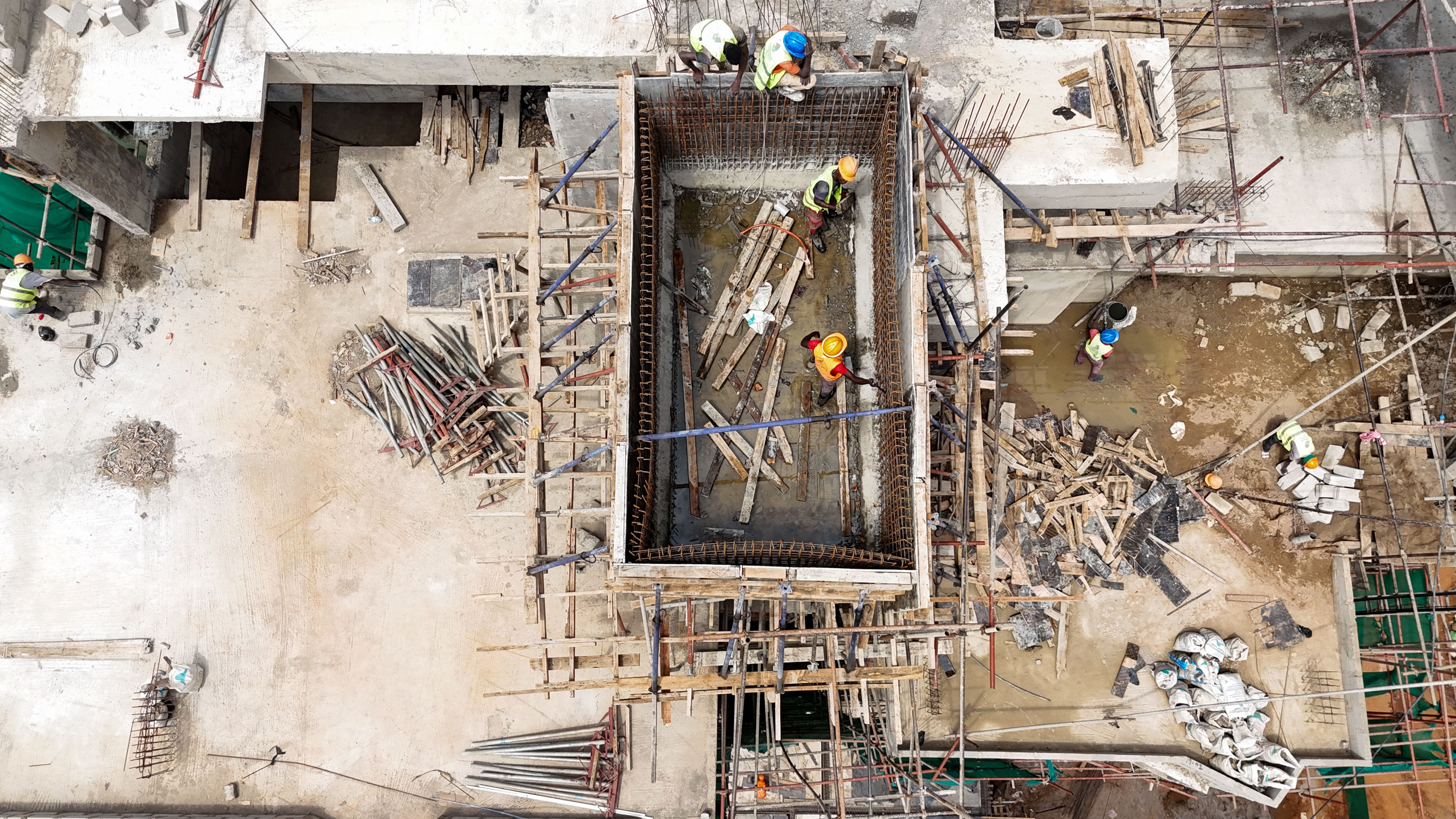

Over in Wing B, water tank steel and shuttering work are progressing steadily. Meanwhile, terrace blockwork is already 80% complete, marking a significant milestone for upper-level spaces.
The remaining photos reflect the ongoing terrace work across both Wings A and B.
Every step brings us closer to delivering a space that blends functionality, quality, and design — and we’re excited to share these milestones with you.
This month marks strong progress across multiple fronts of the project. External plastering is now fully completed, signaling a major finishing milestone. Podium-level structural works are actively progressing between Wings A and B, with a 50% completion target in sight. Finishing activities like waterproofing, tiling, final paint, and China mosaic work are underway across various zones. On the upper levels, terrace blockwork nears completion, while reinforcement and shuttering for water tanks continue. Overall, the site is moving steadily toward final-stage completion with coordinated efforts across all key areas.
We’ve completed the external plastering, giving the buildings their finished look and moving one step closer to the final vision. At the podium level between Wings A and B, steel and shuttering work is actively progressing, with a goal to reach 50% completion soon — a key part of the shared spaces you’ll enjoy.
Up above, work continues on:
Lift and water tank slabs, where teams are carefully applying a durable decorative finish for both protection and visual appeal.
Waterproofing and tiling are starting in some areas — small but meaningful steps toward long-lasting protection and comfort.
The skylight zone has received its final coat of paint, and we’re now preparing to install sleek, reflective glass panels that will brighten and modernize the space.
In Wing B, reinforcement and shuttering for the water tanks is underway, while terrace blockwork is 80% complete — shaping those open-air corners where you’ll relax, host, and create new memories.
These updates may seem technical, but each task brings us closer to a finished community where your future unfolds — and that’s what truly matters.
Habitat 854
Kulambiro, Kampala
May 28, 2025
We design & build with a focus on Sustainable excellence.
Uganda . India . United Kingdom
Copyright © 2021 l All rights reserved.
WhatsApp us
You’ll get a detailed design, overview, location, apartment, and more…
Kindly fill out the quick form and we will be in touch with lightning speed.
